Beyond the Daily Report: What Owners Should Expect from Construction Documentation
A daily construction report can look complete at first glance. The weather is recorded. Crew counts are listed. A few photos are attached. Work performed that day is summarized.
But when a question arises weeks or months later, the real test is whether that report tells the full story.
Strong construction documentation does more than record activity. It gives owners a clear, reliable record of what happened in the field, where it happened, and how the work progressed. When documentation is consistent and detailed, it can help owners make informed decisions during construction and provide valuable support during closeout, audits, or disputes.
So, what should an owner expect from the construction documentation being produced on a project?
why documentation matters while work is underway
Strong field documentation gives owners better visibility into construction as it happens.
Clear daily reports and photographs can help identify problems earlier and make it easier to understand what occurred in the field and where. That can be especially important when field conditions change, when work does not conform to the plans or specifications, or when an immediate decision needs to be made for work to proceed.
Documentation can also help owners evaluate changes more efficiently. If a plan detail or note is unclear, for example, a detailed record of what was observed and performed in the field can provide useful context when deciding whether to extend the limits of a project, increase quantities, or request any additional adjustments.
The value is in creating a record that supports decisions while the project is active, not only after the fact.
the minimum information a useful daily report should capture
A useful daily report should allow someone who was not on the jobsite to understand what happened that day.
At a minimum, the report should identify the work performed, the crews on site, workforce counts, equipment used, hours worked, and all locations of the work performed. It should also identify relevant line items, even when no payment quantity is recorded that day.
Specificity matters. A general note stating that a specific work item was completed is far less useful than a record that identifies the exact activity and where it occurred. Depending on the project, that could mean stationing, straight-line mile markers, or another defined location range.
The report should also capture important field conversations that may affect how the work is completed. If an inspector discusses an issue or clarification with a foreman or superintendent, that information can be important to the project record depending on the significance of the issue.
A consistent outline or standardized format can help capture this information without making the report difficult to review.
photo records, testing records, issue tracking, and change documentation
Daily reports are only one part of the construction record.
Photographs should be clear and taken from useful angles, with enough context to make them understandable later. Whenever possible, it is beneficial for photographs to include permanent landmarks and be tied to a specific date, location, and description. A photo may be obvious to the person who took it, but without context, its value can diminish significantly months later.
Testing records and issue documentation are just as important. When nonconforming work is identified, the record should explain what the issue is, why the work does not conform to the plans or specifications, and where it occurred. Field measurements, test results, and photographs should be included when available or applicable.
Corrective action should also be documented through completion. That means recording the issue, communicating it to the appropriate parties, identifying what needs to change, and verifying that the correction was made.

Change documentation should connect back to the field record as well. Daily reports, testing records, RFIs, written authorizations, and change orders should work together to provide support for quantities, approvals, additional work, and compliance with the specifications.
how strong records support decisions, closeout, audits, and claims
The strength of the project record often becomes most apparent when questions arise later.
Complete field documentation can help owners understand why a decision was made, verify quantities, and confirm how an issue was resolved. It can also reduce confusion when there is disagreement about work performed or direction given in the field.

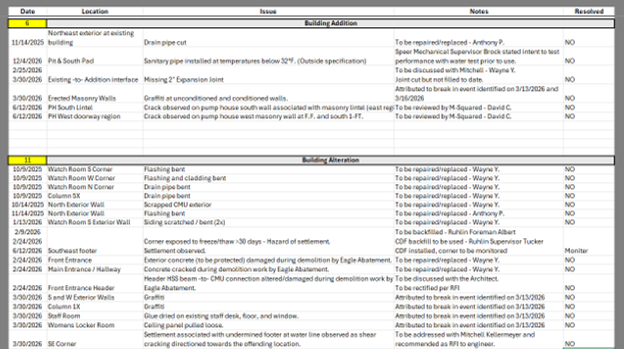

By contrast, incomplete documentation can create problems during closeout, audits, disputes, or claims. Common gaps include work proceeding on verbal authorization without written approval, incomplete change order justification, missing daily reports, and photographs that lack a clear location or description.
These gaps can make it difficult to verify what happened and why. A strong record gives the owner a more defensible history of the project and can help resolve questions before they become larger issues.
Past documentation can also provide useful historical information for future work, particularly when evaluating productivity, quantities, and trends on similar projects.
what owners should request when procuring inspection services
Good documentation starts with clear expectations.
When procuring construction inspection services, owners should define what they expect inspectors to document and how that information should be communicated. The scope should address qualifications and construction experience, daily reporting requirements, testing and quality control standards, and regular communication about project progress, issues, and changes. Safety training requirements should also be identified.
It is also worth establishing expectations for consistency. Reports should follow a general standard format including enough detail to make the project record useful to someone who was not in the field that day.
Mobile field technology can make that process more efficient by improving access to reports, simplifying data entry, and tying photographs to specific dates and locations. But technology does not replace good documentation practices. The quality of the record still depends on the quality of the information being captured.
For owners, that is ultimately the standard that matters.
A daily report should not simply show that documentation was completed. It should contribute to a clear, organized, and reliable record of the project from construction through closeout.
